The Minister of Energy checked the progress of construction of the Orto-Tokoy Hydroelectric Power Station

Юлия Воробьева Exclusive
VK X OK WhatsApp Telegram

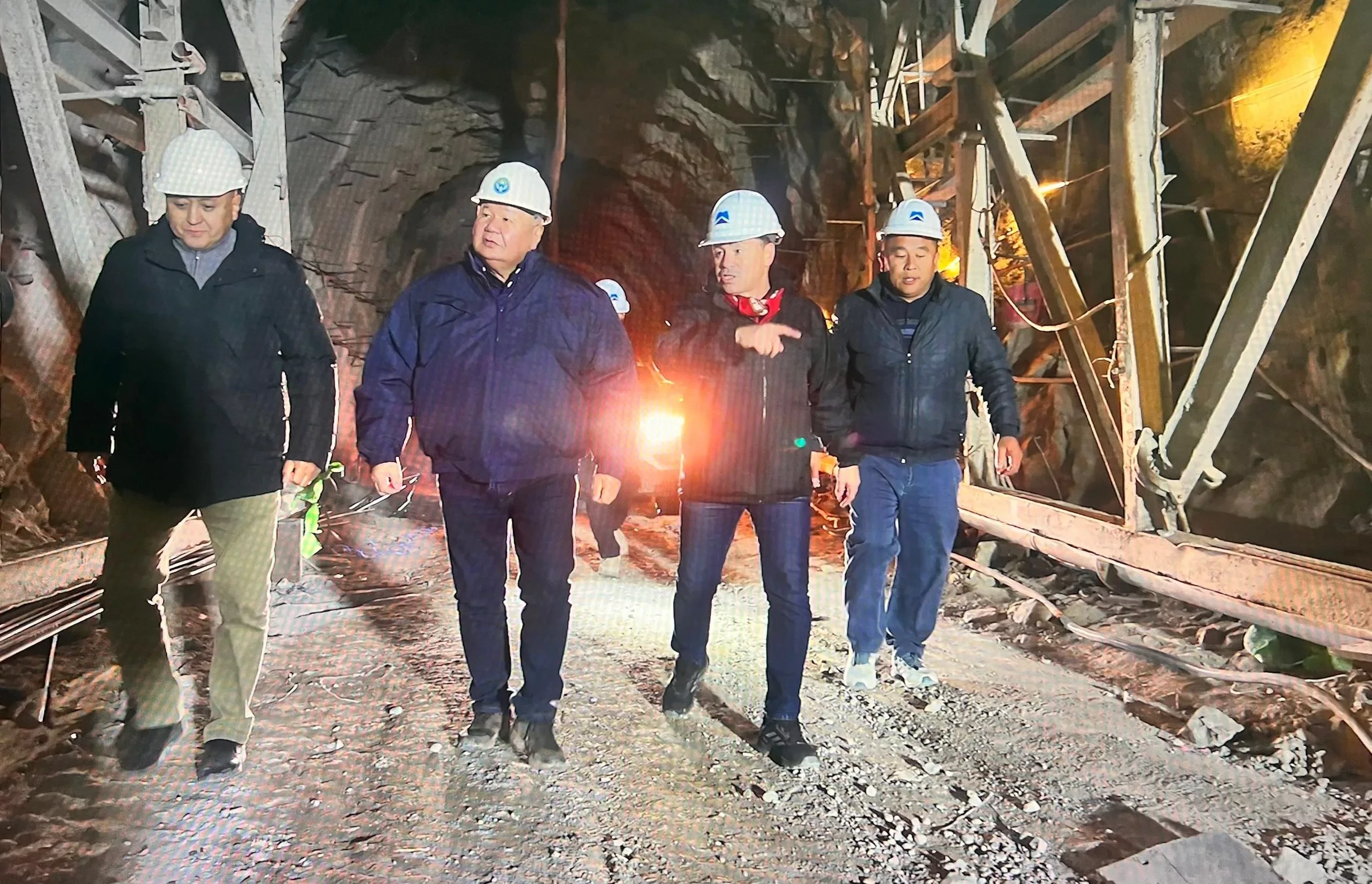

According to Saidov, the work on the water intake has been completed, which allows for effective water accumulation. The diversion tunnel, which is 928 meters long, has also been fully completed, with 624 meters already concreted.

The minister emphasized the importance of adhering to the construction deadlines and instructed Shakir Saidov to strengthen control over the work being carried out.

It is expected that the capacity of the Orto-Tokoy Hydroelectric Power Station will be 21 MW, with the completion of construction scheduled for the first half of 2026.
